Grove Shafter FWY (W)
Eastshore FWY (S)
Nimitz (N)
Bayshore FWY (S)
Bay Bridge Citybound (W)
Cleaveland Heights Detour
Bay Bridge Outbound (E)
S Van Ness Ave (N)
1 Mar - 31 Mar 2023
Bay Bridge repairs
Disruption
management
score
91
/100
Journey times
15%
slower
Journey times through occupation were slower compared to baseline
Below delay limit
97.4%
The percentage of time that the project journey time stayed below the Delay limit
Potential occupation
94.5
hrs
There was potential for a further 21hrs/wk of occupation or 94.5 hrs in total
Incidents
21
The number of incidents recorded in annotations. These lasted a total of 18 hrs
Delay peaks against baseline
Morning peaks
Bay Bridge Citybound (W)
12 min
2 min
Nimitz (N)
23 min
9 min
Afternoon peaks
Bay Bridge Citybound (W)
10 min
1 min
Nimitz (N)
20 min
6min
Synopsis

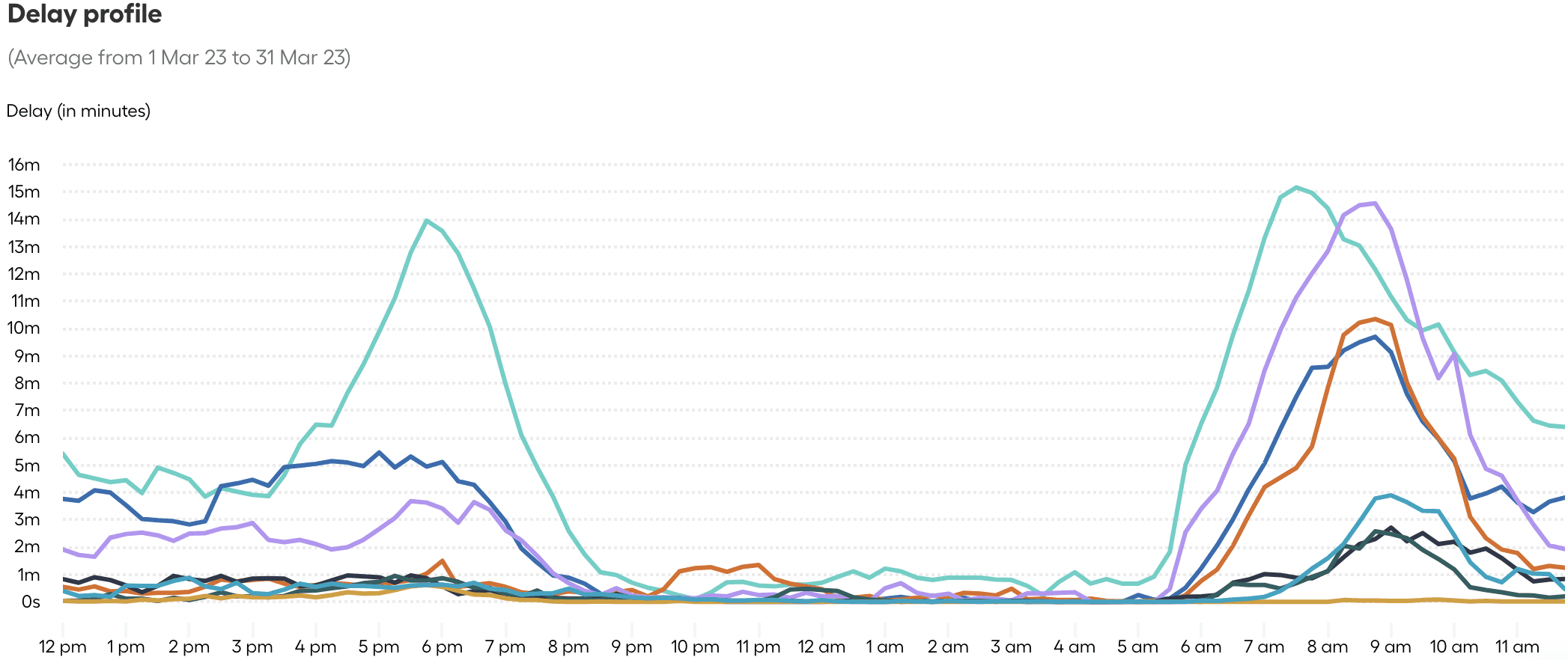

There were peaks on Bay Bridge Citybound (W) at 5 pm nightly however, this was lower than the recorded baseline.
The improved working window appears to be mostly fit for purpose with only slight potential for further occupation.
Occupation
Sun
Mon
Tue
Wed
Thu
Fri
Sat
To learn more about this report, please get in touch with Mooven at support@mooven.com
